Tomato puree is best understood as “season-packed inventory”: a perishable crop converted in a short processing window into shelf-stable bulk that must perform consistently for months in downstream plants. This guide maps the physical flow, the spec levers that change supplier optionality, and the cost nodes that explain why two offers with the same °Brix can drive very different total cost.

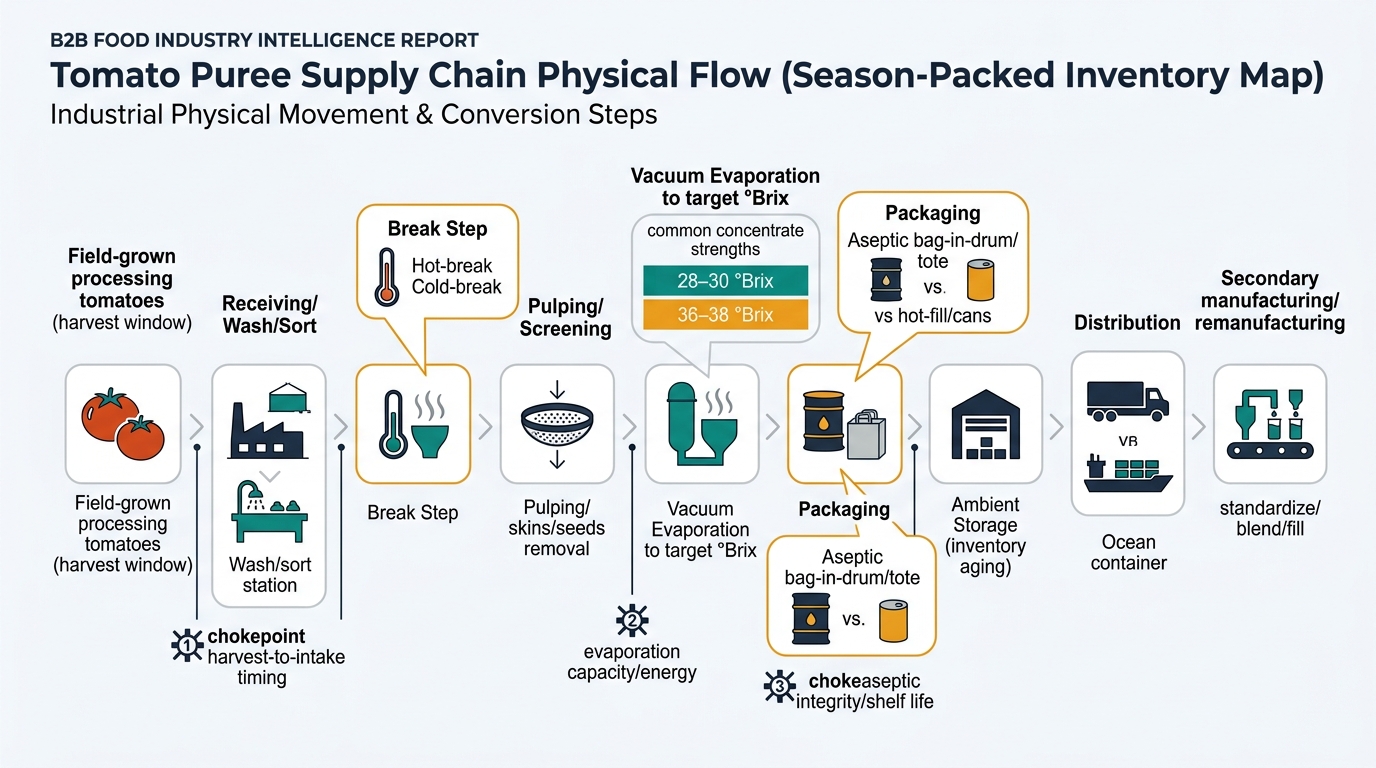

Tomato puree is not a continuous-flow commodity; it is manufactured in a short, high-throughput harvest window, then stored and redistributed as shelf-stable inventory for the rest of the year. Physically, the chain is built around three chokepoints that don’t move much year to year: (1) field harvest synchronized to factory intake, (2) thermal break + evaporation capacity inside processing plants, and (3) packaging formats (especially aseptic bulk) that determine shelf life, handling, and freight efficiency.
Insight: The “map” is dominated by conversion steps (tomato → pulp → concentrate/puree) and by packaging choices that lock in shelf life and logistics cost.
Data (validated): Industrial tomato processing commonly includes a hot-break or cold-break heat step (to control enzyme activity and texture), screening to remove skins/seeds, and vacuum evaporation to a target °Brix (soluble solids). (General process description is consistent with industry practice; avoid relying on a single vendor blog as the only authority.)
Procurement Impact: Even before commercial decisions, the physical system fixes where costs accumulate: yield/solids at intake, energy and uptime in evaporation, and packaging + handling in bulk formats.

Insight: Tomato puree cost is a stacked conversion cost: agricultural yield becomes “solids,” solids become “concentrate,” and concentrate becomes “packaged inventory.” Every node adds cost via yield loss, energy, packaging, compliance, and working-capital time.
Data (validated): Break-step temperature regimes (hot vs. cold) change texture outcomes by influencing pectin-related enzyme activity; concentration targets are specified by °Brix bands across the industry (buyers often see 28–30°Bx and 36–38°Bx for paste/concentrate). [3]
Procurement Impact: Understanding which node is doing the “value-adding physics” (enzyme control, evaporation, aseptic integrity, retail fill) is the foundation for interpreting why two offers with the same headline spec can behave differently in your plant.

| Supply Chain Node | Cost Ratio (% of Final Cost) | Notes |
|---|---|---|
| Raw Material Cost (tomatoes + field-to-plant) | 35% | Driven by delivered solids and harvest/logistics synchronization. |
| Primary Processing (break/screen/evaporate) | 25% | Energy/steam, evaporation time, yield loss, plant uptime. |
| Packaging & QA (aseptic bag + drum + release testing) | 15% | Aseptic consumables, drums, sampling, micro release, traceability. |
| Logistics & Distribution | 10% | Container utilization, inland drayage, warehousing/handling. |
| Secondary Processing / Standardization | 10% | Blending, re-thermal processing, rework/waste. |
| Distributor/Service Margin | 5% | Physical service layer: storage, breaks, local delivery. |
| Supply Chain Node | Cost Ratio (% of Final Cost) | Notes |
|---|---|---|
| Raw Material Cost | 30% | Solids per ton matters more than tonnage. |
| Primary Processing | 35% | More evaporation work per ton vs. lower-Brix products. |
| Packaging & QA | 15% | Aseptic integrity + drum system. |
| Logistics & Distribution | 10% | Higher density improves freight efficiency vs. puree. |
| Secondary Processing / Remanufacturing | 0–5% | Often sold as an input; remanufacturing occurs downstream. |
| Distributor/Service Margin | 5–10% | Depends on channel and inventory holding. |
| Supply Chain Node | Cost Ratio (% of Final Cost) | Notes |
|---|---|---|
| Raw Material Cost | 25% | Highest sensitivity to solids and screening losses. |
| Primary Processing | 40% | Evaporation energy/time dominates; throughput constraints matter. |
| Packaging & QA | 15% | Similar packaging cost, higher value per drum. |
| Logistics & Distribution | 8% | Best freight efficiency per unit solids. |
| Secondary Processing / Remanufacturing | 2% | Typically downstream dilution/standardization into sauces/puree. |
| Distributor/Service Margin | 10% | Higher working-capital value held in inventory. |
Insight: Viscosity/consistency is not guaranteed by Brix alone; it is materially shaped by hot-break vs. cold-break processing and raw fruit condition.
Data (validated): Hot-break processes are designed to inactivate pectin-related enzymes and typically yield higher viscosity; cold-break leaves more enzyme activity and is used when different texture/flavor outcomes are desired. [3]
Procurement Impact: Two materials with identical Brix can drive different line behavior (pumpability, fill weight control, rework), so “fit-for-purpose” requires capturing both solids and functional texture parameters.
Insight: The supply chain is structurally dependent on aseptic packaging performance because it enables long ambient storage.
Data (validated): Aseptic bulk tomato paste/concentrate is commonly specified with ~18–24 months shelf life under ambient conditions (subject to supplier validation and storage). [1]
Procurement Impact: The physical failure mode is binary (loss of sterility) but the financial impact is nonlinear (entire lots, customer complaints, brand exposure), making packaging/QA a core cost node—not overhead.
Insight: Higher Brix concentrates move “more tomato solids per container,” structurally improving freight and warehouse efficiency, but they also demand more evaporation work upstream.
Data (industry practice): Commercial concentrate strengths are commonly traded in defined bands (buyers often encounter 28–30°Bx and 36–38°Bx).
Procurement Impact: The physical trade is fixed: you either pay more upstream energy/capacity to ship less water, or you ship more volume and pay more logistics/space downstream.
(Analyzed at: May, 2026)
With 2026 global processing-tomato supply currently forecast around ~39.8–40 million tonnes (i.e., not a clear shortage signal on its own), your best leverage is to contract around the chokepoints, not the headline price: lock in capacity and service by specifying break regime + functional consistency metric alongside °Brix, and add explicit aseptic integrity/claims terms because that’s where long-tail write-offs originate. [2] If you tighten those three specs and protections, you typically prevent the expensive failures—line slowdowns, rework, and late-cycle inventory disposal—that can easily outweigh a small unit-price win over a season’s volume.
